Subian Electric Power Launches New Pad Mounted Transformer

A utility procurement manager based in the Philippines came across an RFQ for 140 pad-mounted transformers – dead-front, 25 kV and three-phase type with the delivery time of 16 weeks and that had already been rejected by two overseas suppliers. The search for a manufacturer that would fulfill the IEEE C57.12.27 specification and whose prices would allow for keeping within the budget pushed the manager to a Chinese business – Jiangsu Subian Electric Power which has made a significant upgrade of its product line and which just launched a new pad-mounted transformer series specifically intended for export customers who are interested in acquiring certified quality at a more reasonable price without facing the backlog that is typical for the regular supply chain.

This paper will analyze what products the new Subian pad-mounted transformer line offers, how it is tested and where it stands in the market, what costs it can incur and what comments one should make about the evaluation of any supplier.

What Was Launched

The Jiangsu Subian Electric Power launched its new line of pad-mounted transformers which includes dead-front and liquid-immersed distribution transformers designed according to the standards of the IEEE C57.12.00 with an option of three-phase or single-phase along with all routine testing documents. With this launch, the company is introducing a series of products including its existing oil-immersed and dry transformers, as well as its prefabricated substations.

The key features of the new line are worth examining individually, because each one maps to a specific buyer concern:

Feature Detail Buyer Benefit
Dead-front construction IEEE 386 separable connectors, shielded and grounded No exposed live parts; meets IEEE C57.12.27 tamper-resistance
Copper windings standard High-conductivity electrolytic copper Lower losses and higher reliability over the asset life
Per-unit loss testing No-load and load loss measured on each unit Verified losses for honest total-cost-of-ownership comparison
Grain-oriented core steel High-permeability steel with step-lap joints Low no-load losses and quiet operation (≤55 dB(A))
Hot-dip galvanized enclosure Corrosion-protected cabinet, lockable 20+ year outdoor life in coastal and humid climates
Export packing Containerized with steel skids and desiccant Safe ocean transport and site handling

Why the Launch Matters

The global market for pad-mounted transformers is experiencing ongoing tight supply. Demand for them due to power grid improvements, solar energy and storage connections, and electrification efforts has stretched lead times at many manufacturing facilities in Europe and the US over 30 weeks and has driven prices up. This is a real problem for buyers in Southeast Asia, the Middle East, Africa, and Latin America since finding an acceptable vendor with good quality products within a short period of time and reasonable prices has been rather challenging.

A product launch like this is important because it offers another option which is backed by three structural advantages:

Lead time – 10-20 weeks production time instead of 30 weeks and more in traditional factories;
Cost – prices 30-45% lower than Western prices for comparable classes of rating and losses;
Flexibility – manufacturing adjustment of bushings, taps, additional appliances, and painting according to the project.

This combination, which implies meeting project deadlines and budgets that could hardly be achieved without it.

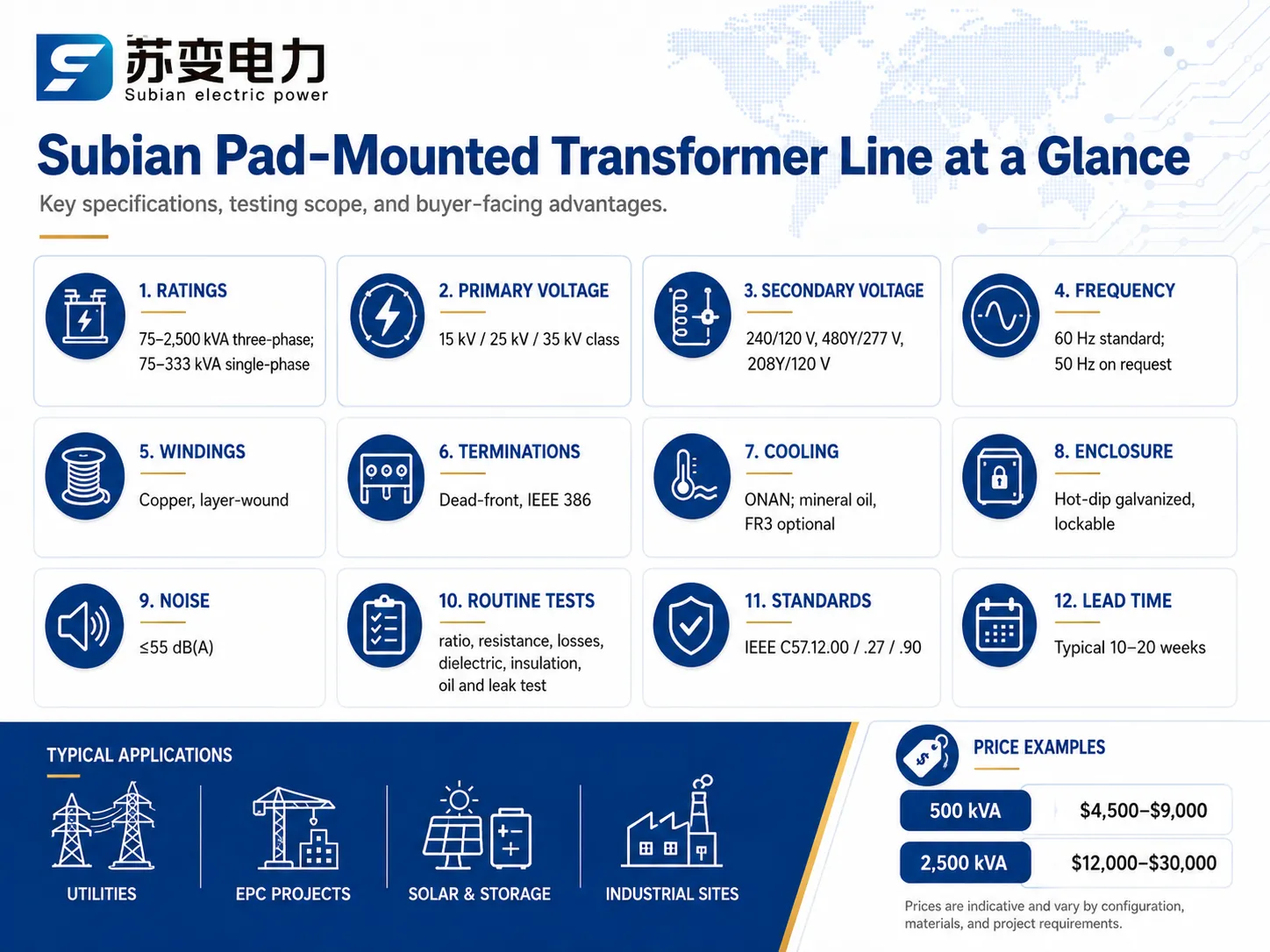

Key Specifications of the New Line

Parameter Value
Ratings 75–2,500 kVA (three-phase); 75–333 kVA (single-phase)
Primary voltage 15 kV, 25 kV, 35 kV class
Secondary voltage 240/120 V, 480Y/277 V, 208Y/120 V
Frequency 60 Hz (50 Hz available on request)
Windings Copper, layer-wound, thermally upgraded paper insulation
Impedance 1.4%–5.75% per IEEE C57.12.00
Terminations Dead-front, IEEE 386 loadbreak or deadbreak
Enclosure Hot-dip galvanized steel, lockable, IEEE C57.12.27
Cooling ONAN, mineral oil (FR3 available)
Noise ≤55 dB(A) at 1 m
Standards IEEE C57.12.00, C57.12.27, C57.12.90

For a 500 kVA, 25 kV unit, typical measured losses are around 0.9–1.2 kW no-load and 5.8–8.0 kW load loss at 85°C — figures that should be requested per unit and compared against the design sheet before acceptance.

Quality and Testing Approach

The quality approach of the new line is based on verifiable data, not marketing verbiage. The units undergo a standard testing program in conformity with the requirements of IEEE C57.12.90 prior to shipping.

Ratio and vector group check
Measurement of the resistance of windings in all the phases
Measurement of No-load losses and excitation current in rated voltage
Measurement of load losses and impedance in rated current and at 85°C
Dielectric tests with applied voltage and with induced voltage applied
Measurement of insulation power factor and insulation resistance
Pressure/vacuum leak test of the tank
Dielectric strength of oil check

Type tests, including full-wave impulse test, chopped-wave test, temperature rise test, testing of the effect of short circuit, are conducted on one representative model from each design group. The test protocols can be obtained upon request. For those clients who require independent confirmation of the test results at the factory, the factory provides a possibility for third party inspection.

Market Position and Price

Jiangsu Subian Electric Power positions the new pad-mounted line in the cost-effective tier between premium international brands and commodity suppliers. The value proposition is not “cheapest” — it is certified IEEE-compliant quality, documented losses, and export service at a price that typically lands 30–45% below Western equivalents.

Rating Voltage Class Indicative Price (USD) Lead Time
150 kVA (single-phase) 15–25 kV $1,800–$3,500 8–14 weeks
300–500 kVA 15–25 kV $4,500–$9,000 10–16 weeks
750–1,000 kVA 25–35 kV $8,500–$16,000 12–18 weeks
1,500–2,500 kVA 25–35 kV $12,000–$30,000 14–20 weeks

Prices are indicative FOB and vary with specification, copper content, accessories, and region. Buyers should always request a per-unit loss certificate to compare on evaluated total cost rather than first price.

Subian vs. Global Competitors

Brand Country Lead Time Price (500 kVA) Best For
Prolec GE USA/Mexico 20–35 weeks $6,500–$12,000 US utility tenders, local service
Hitachi Energy Switzerland 20–30 weeks $7,000–$13,000 Global projects, brand assurance
Siemens / Schneider / Eaton Europe/USA 20–35 weeks $6,500–$13,000 Integrated distribution solutions
Commodity Asian suppliers Asia 8–14 weeks $3,500–$6,000 Price-only purchases
Jiangsu Subian Electric Power China 10–20 weeks $4,500–$9,000 Certified quality at export-competitive cost

When it comes to making a decision, buyers should compare three categories. The first one is the already-established Western brands that offer high-quality registration and customer service. The second one is the suppliers that have the best prices, however, have little or poor documentation. The third and final one is the one that we represent, which is the IEEE/IEC certified suppliers that provide their clients with all the certifications, strict testing procedure, and OEM capabilities. Our products will fit into the market, where neither the premium, nor the commodity category suits the client.

Standards Behind the Product

Standard Role
IEEE C57.12.00 General requirements: ratings, impedance, accessories, nameplate
IEEE C57.12.27 Enclosure integrity: dead-front, tamper resistance, locking
IEEE C57.12.90 Test procedures: losses, dielectric, impulse, short-circuit
IEEE 386 Separable connector systems for dead-front terminations
IEC 60076 International alternative for 50 Hz and non-US projects
DOE 2016 Efficiency Minimum efficiency levels for US-bound units

When buying from any manufacturer, ask which standards the design is tested to and request the actual test reports. For US-bound shipments, confirm DOE efficiency compliance; for 50 Hz markets, confirm the IEC 60076 test basis.

Application Areas

Residential areas: There are underground distribution units with single-phase capacity ranging from 75-167 kVA.

Business buildings: There are three-phase units with capacity from 300-1,000 kVA used in shopping centers, schools, hospitals, and offices.

Manufacturing units: There are units that can be from 1,500-2,500 kVA used in factories, warehouses, and data centers.

Solar and storage connection: There are pad-mounts used to increase inverter capacity for generating networks.

модернизация распределительных сетей: The old pole-mounted power units are being replaced with dead pad-mounted ones.

Temporary power: There are portable pad mounts used in the construction site as well as at large events.

Price Ranges by Rating

Realistic price expectations for the new Subian line (FOB, copper windings, dead-front, standard accessories):

Configuration Typical Price (USD) Lead Time
75 kVA single-phase, 15 kV $1,500–$2,400 8–12 weeks
150 kVA single-phase, 25 kV $1,800–$3,500 8–14 weeks
300 kVA three-phase, 25 kV $3,200–$6,000 10–16 weeks
500 kVA three-phase, 25 kV $4,500–$9,000 10–16 weeks
1,000 kVA three-phase, 35 kV $8,500–$16,000 12–18 weeks
2,500 kVA three-phase, 35 kV $12,000–$30,000 14–20 weeks

Accessories such as surge arresters (+$100–$400), loadbreak elbows (+$50–$200 per termination), and FR3 vegetable oil (+8–12%) add to the base price. These figures are indicative and vary with specification, brand, and region.

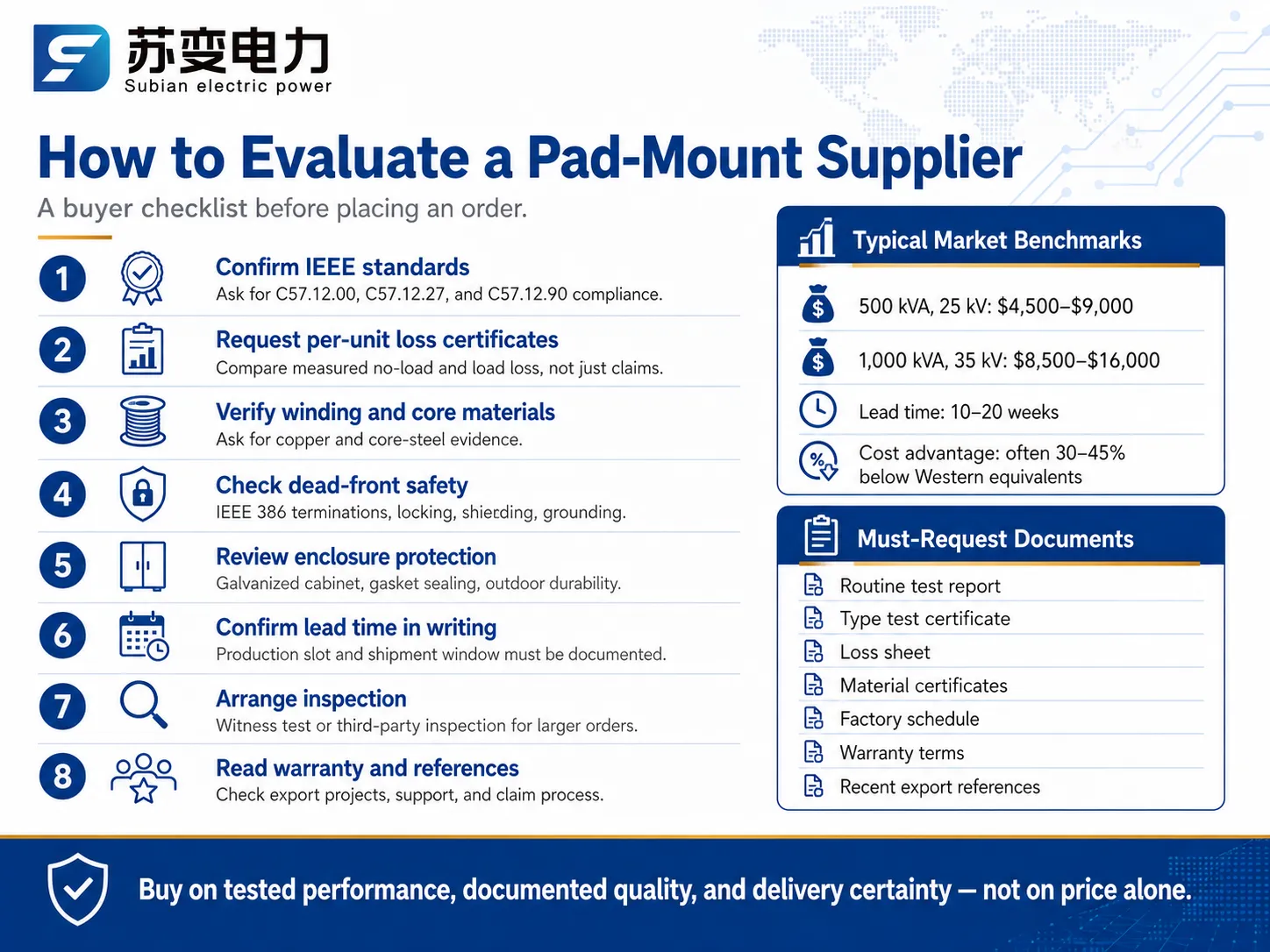

Evaluating Any Suppliers of Pad-Mount Equipment

Request for the standards to be assured of compliance to IEEE C57.12.00/.27/.90.

Demand for per-unit loss certificates – this must be measured and compared to evaluated cost over 25 years.

Verify winding material and core steel by requesting for material certificates.

Check the enclosure: dead-front construction, locking mechanism, corrosion protection and gasketing.

Get a confirmation of lead-time in writing and check the factory’s output schedule.

Carry out a witness to the test of a third party inspector before the consignment is dispatched especially for big requests.

Go through warranty periods in terms of years and scope of the warranty and also how claims are covered globally.

Frequently Asked Questions

What is included in the new Subian pad-mounted transformer line?

The line covers 75–2,500 kVA three-phase and 75–333 kVA single-phase pad-mounts, 15–35 kV class, with dead-front IEEE 386 terminations, copper windings, hot-dip galvanized enclosures, and per-unit loss testing per IEEE C57.12.90. Units ship with complete routine-test documentation and are available with OEM customization for export projects.

How much does a Subian pad-mounted transformer cost?

Indicative pricing: $1,500–$2,400 (75 kVA single-phase), $4,500–$9,000 (500 kVA three-phase), $8,500–$16,000 (1,000 kVA), and $12,000–$30,000 (2,500 kVA). This is roughly 30–45% below Western equivalents. Prices are FOB and vary with copper content, accessories, and region.

How long is the lead time?

Production slots are typically 10–20 weeks depending on rating and factory workload — significantly faster than the 30+ weeks common at US and European plants. Buyers should confirm slots in writing early, especially for large volumes.

Does the line meet North American standards?

Yes. The design follows IEEE C57.12.00, IEEE C57.12.27, and IEEE C57.12.90, with IEEE 386 dead-front connectors. For US-bound units, DOE 2016 minimum efficiency levels are confirmed. For 50 Hz export markets, IEC 60076-compliant versions are available.

Can units be customized?

Yes. OEM/ODM options include tap configurations, bushing types, secondary voltages, painting and logo, accessories such as surge arresters and loadbreak elbows, FR3 vegetable oil, and 50 Hz versus 60 Hz designs. Customization extends lead time by 2–4 weeks.

References

Conclusion

Jiangsu Subian Electric Power’s new pad-mounted transformer line addresses a real gap in the market: IEEE-certified quality, documented testing, and OEM flexibility at lead times and prices that global projects can actually absorb. The launch gives EPC contractors, utilities, and developers an additional, credible source at a time when distribution transformer supply is tight worldwide.

Key takeaways:

  • Demand standards compliance and per-unit loss certificates from any pad-mount supplier.
  • Compare on evaluated losses and total cost of ownership, not first price.
  • Confirm lead times in writing and arrange third-party inspection for large orders.
  • Balance established Western brands against IEEE-certified suppliers like Jiangsu Subian Electric Power.

For pad-mounted transformer pricing, specifications, and export support, contact Jiangsu Subian Electric Power at www.subian-electric.com.
